A slow month-end close does not automatically mean the ERP is the problem.
Finance may be waiting on late source data, unresolved reconciliations, journal approvals, intercompany balances, spreadsheet rollups, or reports that still need to be rebuilt after the ledger is technically complete.
In other cases, the ERP really is part of the constraint. Reporting structures may no longer fit the business. Integrations may be fragile. Consolidation may be manual. Normal close activities may require too many exports, workarounds, or repeated data checks.
From the outside, both situations look the same:
The numbers are late.
If the month-end close takes too long, map the process before changing software
Follow the close from source data through posting, reconciliations, approvals, consolidation, reporting, and final sign-off. Then look for four things:
- Where people are actively working
- Where the process is waiting
- Which steps are repeated
- Which exceptions require manual intervention
If system limitations repeatedly create the bottleneck, the ERP belongs in the solution. If ownership, timing, controls, or work practices are the main constraint, process redesign should come first.
This guide separates ERP constraints from process problems and shows where the two overlap
What actually makes a month-end close slow?
Financial close is not one task. It is a chain of dependent activities
Transactions need to be complete enough to post. Accounts must be reconciled. Exceptions must be investigated. Journals and adjustments may require review. Intercompany activity needs to be lined up. Reports must be produced and checked before someone can finally sign off on the period.
Sage’s current financial close checklist describes a close that includes reconciliations, journals and accruals, review and variance analysis, and final sign-off. Oracle’s period-end close guidance similarly identifies common activities such as posting, reconciliations, accruals, integrity checks, period closing, and reporting.
For a broader look at improving the process itself, ADSS Global also has a guide to financial close optimization and shortening month-end close.
The important point is that close crosses systems, people, data, and controls.
The ERP may be part of the bottleneck. It is rarely the only place worth looking at.
| Close area | What a delay may look like | The first question to ask |
| Source data | Finance waits for payroll, expenses, billing, inventory, or another team | Why is the data late or incomplete? |
| Posting | Batches, journals, accruals, or allocations are still being created after cut-off | Could more work happen before period end? |
| Reconciliations | Differences are repeatedly researched or rebuilt in spreadsheets | Is the issue missing data, weak matching, or unclear ownership? |
| Approvals | Completed work sits in a queue for review | Is the bottleneck workflow technology or reviewer availability? |
| Integrations | Finance waits for interfaces, imports, or file transfers | Is the feed late, unreliable, or difficult to verify? |
| Consolidation | Entity results are manually combined or intercompany differences delay group reporting | Is the system structure creating unnecessary work? |
| Reporting | The ledger is closed but management reports still take days | Is reporting part of the close design or a separate manual process? |
A useful diagnosis starts by locating the delay rather than assuming the cause.

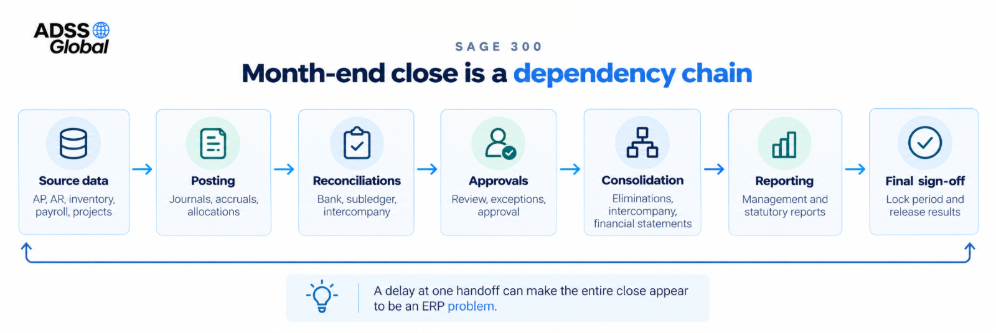

Figure 1. Month-end close is a dependency chain; a delay at one handoff can hold the entire reporting cycle.
First Measure Where the Close Is Spending Time
Before discussing automation or a new ERP, track the close for two or three periods. For each major activity, record:
- when it was ready to start
- when work began
- when it finished
- who owned it
- what it depended on
- whether rework or an exception occurred
This separates work time from wait time.
APQC defines close cycle time as total elapsed time, including active work and waiting. Its current cross-industry benchmark for finance shared-services centers reports a median of 8.0 days. Useful context, but not the diagnosis. The real question is where elapsed time accumulates in your own close
If a reconciliation takes two hours but cannot start for two days because source data is late, automating the reconciliation does not remove the two-day delay. If an approval takes five minutes but sits overnight, the problem is not the accounting entry. If reporting takes three days after the ledger is closed, finance may have a reporting problem even though the accounting close is technically complete.
That is why a close calendar should show dependencies, not just due dates.
“Bank reconciliation due Day 3” is less useful than:
“Bank reconciliation can begin once bank feeds and cash postings are complete; material unexplained items require controller review.”
Reporting Problems Can Make a Closed Ledger Feel Unclosed
A ledger can be technically closed while finance is still working. If the team still needs to export data, rebuild reports, combine entity workbooks, reclassify rows, add commentary, or resolve conflicting report versions, leadership does not experience the close as finished.
That delay may point to the ERP when:
- reporting structures no longer fit the business
- cross-entity reporting is difficult
- dimensional reporting is limited
- too much reporting logic is embedded in the chart of accounts
- reports require repeated manual manipulation
But reporting delays can also be process problems. Teams may maintain several versions of the same report, use inconsistent filters, change spreadsheet logic each month, or rely on one person who knows how the management pack works.
Ask one question:
If the underlying data were available immediately, could finance produce the required reports without rebuilding them manually?
If the answer is no because the system cannot represent the required reporting structure, that points to a technology constraint. If the answer is no because definitions, ownership, or report logic are inconsistent, process design comes first.
For teams already using Sage Intacct, ADSS Global’s guide to building better financial reports in Sage Intacct goes deeper into reporting structure and dimensions.
Reconciliations: Is the Work Manual, or Is the Exception Rate the Real Problem?
Reconciliations often consume a large part of the close because they sit where transaction data, subledgers, bank activity, interfaces, and judgment meet.
The first step is to separate routine matching from exception investigation.
If accountants spend hours manually matching high-volume transactions that follow consistent rules, automation may remove genuine effort. If most of the time is spent investigating unexplained differences, however, the important question is why those differences exist.
They may come from late postings, inconsistent cut-offs, integration failures, incorrect account mapping, duplicate entries, timing differences that are not categorized consistently, or upstream teams changing data after finance has started reconciling. In that case, automating the final reconciliation can make the work faster without fixing the source of the exceptions.
| Signal | More likely a system constraint | More likely a process/control constraint |
| High-volume matching is repetitive and rule-based | Limited matching or automation capability | Rules have never been standardized |
| The same unexplained differences return every month | Integration or mapping defect may be contributing | Root causes are repeatedly carried forward instead of resolved |
| Reconciliations wait for source files | Interface or data-access limitation may exist | Cut-off or ownership is unclear |
| Review takes longer than preparation | Workflow may not route or surface exceptions well | Reviewer capacity or approval criteria are unclear |
| Finance rebuilds support in Excel every month | System may not retain usable reconciliation detail | Templates and evidence requirements may not be standardized |
The key is to diagnose whether technology is creating the manual work or whether technology is being asked to compensate for an unstable process.
Approval Delays Are Often Queue Problems
Approvals can slow the close even when the accounting work is already finished.
A journal may be ready on time but sit until the next day for approval. An accrual may pass through three reviewers even when the amount is small. A reconciliation may come back because nobody agreed on what supporting evidence was required.
Those delays matter, but they are not automatically ERP problems.
Technology may be part of the issue when approval routing is difficult, status is hard to see, reminders are manual, or reviewers cannot easily access the information they need.
The process itself may be the problem when there are too many approvers, weak approval thresholds, no backup reviewer, or no clear definition of what is ready for approval.
That is why a close review should measure queue time separately from review time.
If a journal takes six hours to move from submission to approval, but the reviewer spends four minutes on it, the real question is:
What happened during the other five hours and 56 minutes?
Data Problems Usually Start Upstream of Finance
Month-end close can only move as quickly as the data finance receives.
Late expense submissions, incomplete billing, inventory adjustments, payroll feeds, missing purchase receipts, delayed bank activity, and inconsistent master data can all push work into the close window.
By the time finance sees the problem, the cause may sit in another department or another system.
If finance repeatedly fixes coding, dimensions, or master data before reporting, trace the problem back to where the data was created. If the same transactions need to be recorded every month, ask whether the cause is the source system, ERP configuration, data design, training, or unclear ownership.
An ERP can enforce required fields, automate validation, centralize master data, and reduce duplicate entry.
It cannot make another team submit information on time or resolve a policy nobody owns.
A recurring problem that users cannot reasonably avoid within the current system points toward a technology constraint. Data that could be completed earlier but is not because ownership, cut-offs, or expectations are unclear points more strongly toward a process problem.
Integrations Can Turn the Close into a Waiting Exercise
A finance team may use one ERP and still depend on payroll, expense, ecommerce, banking, CRM, warehouse, billing, or industry-specific systems to complete the period.
That means the close is only as predictable as the data flows between those systems.

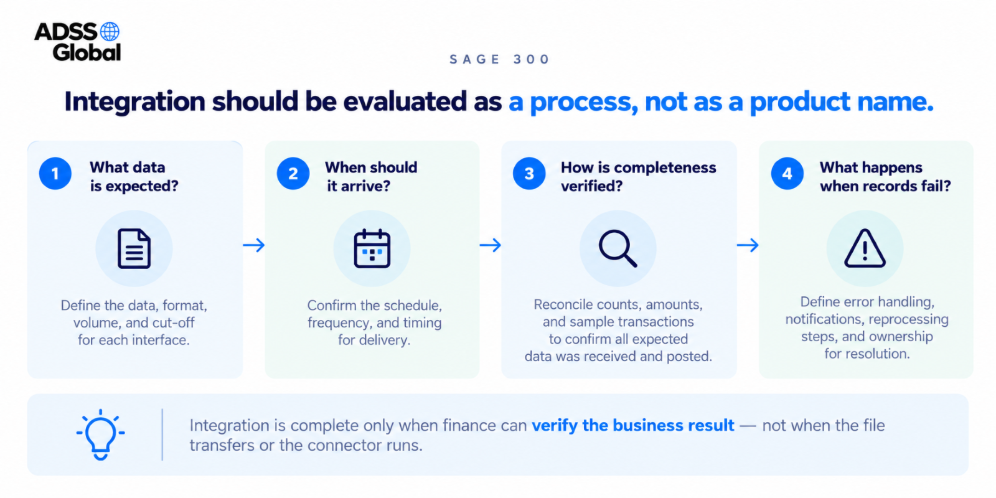

Evaluate the data flow itself: what should arrive, when it should arrive, how completeness is proved, and who owns failures
What data is expected?
When should it arrive?
How is completeness verified?
What happens when records fail?
Who owns the source system, the connection, and the finance-side reconciliation?
A feed can run successfully while still being incomplete. A file can transfer while rows fail validation. An API can be online while transactions remain in an exception queue. For close purposes, “the integration ran” is weak evidence. Finance needs a business-level control that confirms the expected records arrived and were posted correctly.

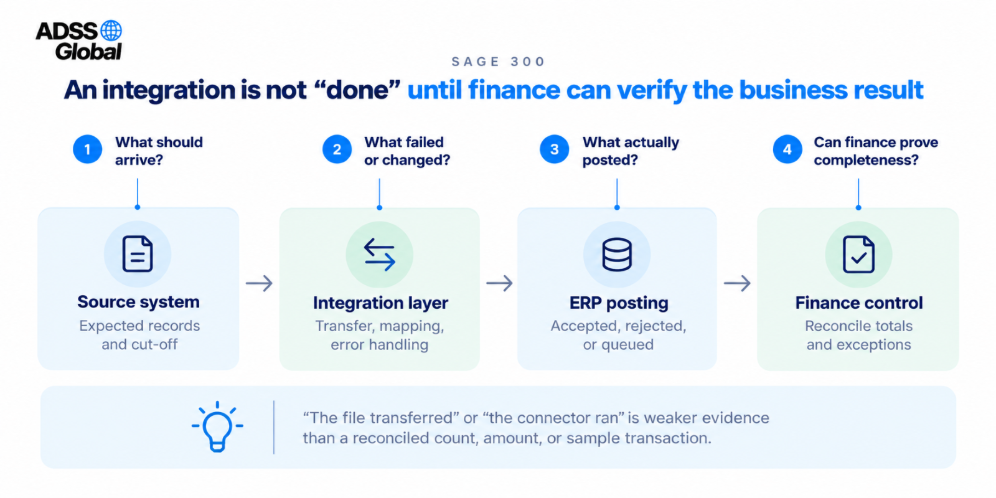

Figure 2. Integration controls should verify the expected business result, not only whether a file or connector ran.
If an interface fails only during peak period-end volume, requires frequent manual restarts, or cannot provide usable error information, the ERP or integration architecture may be a genuine technical constraint.
ADSS’s integrations and connected solutions page is a useful reference when mapping systems around a Sage environment, but the diagnostic principle applies regardless of which applications are connected.
Spreadsheet Work Is Not Automatically a Problem
Spreadsheets are easy to blame because they are visible. But not every spreadsheet is a problem.
Excel can still be useful for analysis or controlled close schedules. The risk starts when a workbook becomes an undocumented subsystem: it combines multiple data sources, contains business-critical logic, depends on manual copy-and-paste, or is understood by only one person.
Ask instead: ‘What role is Excel playing because the current process or system does not?
It is:
“What role is Excel playing because the current process or system does not?”
If a workbook exists because the ERP cannot handle an allocation, consolidation, reconciliation, or report efficiently, that points to a system gap.
If it exists because the process is not standardized, users prefer a familiar format, or ownership is unclear, the better fix may be training, governance, or process redesign.
A useful review is to separate spreadsheets into three groups:
- Analytical tools
- Controlled close schedules
- System substitutes
The third group deserves the most attention during an ERP evaluation.
Multi-Entity Close Problems Need a Separate Diagnosis
Multi-entity organizations add another layer of dependency to the close.
Each entity may finish on time while group reporting is still delayed by intercompany mismatches, currency translation, inconsistent structures, late submissions, or manual eliminations.
That is why entity close and group close should be measured separately.
Technology may be part of the problem when finance has to manually combine results from separate databases, manage intercompany activity outside the system, or rebuild consolidated reporting each month.
But a new ERP will not fix unclear intercompany policies, inconsistent cut-offs, different local chart practices, or weak ownership between entities.
If one entity closes on Day 2 and another continues changing numbers on Day 6, consolidation technology is only part of the problem.
ADSS Global has additional resources on multi-entity management in Sage Intacct.
Those capabilities matter most after the business has defined the entity structure, intercompany rules, reporting model, and controls the system needs to support.
ERP Problem, Process Problem, or Both? Use This Diagnostic
By this point, most slow-close issues can be placed into one of three categories.
| Diagnostic category | What the evidence looks like | Typical response |
| Primarily process | The current system can support the required work, but tasks start late, ownership is unclear, approvals wait, policies differ, or exceptions are not resolved | Redesign the close calendar, ownership, cut-offs, controls, and standard work before changing software |
| Primarily ERP/system | Repeated manual work is required because the current system cannot support reporting, consolidation, workflow, matching, integration, or data structure requirements efficiently | Evaluate configuration changes, add-ons, automation, or a different financial platform |
| Both | The process has grown around system limitations, creating workarounds that are now embedded in how finance operates | Redesign the target process and system together; do not simply migrate the current workflow unchanged |

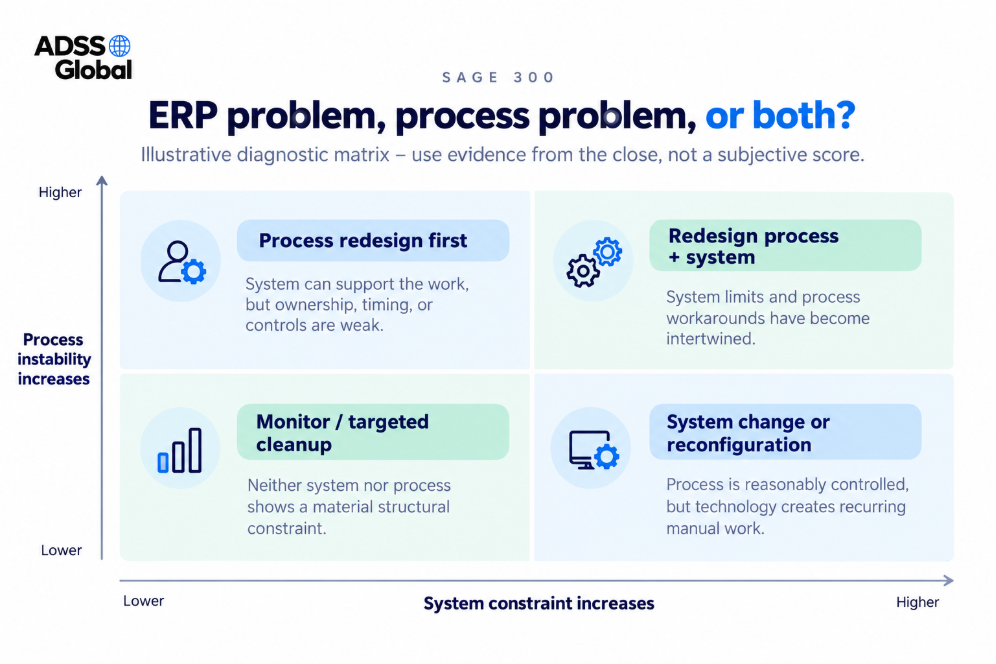

Figure 3. Use evidence from the close to distinguish system constraints, process instability, and problems that require both to change.
That is why the decision should not be framed as “fix the process or replace the ERP.” The more useful question is: which constraints should disappear in the target process, and what combination of system capability, configuration, ownership, and operating discipline is required to remove them?
A Five-Step Diagnostic Before You Recommend Software Change
A finance team does not need a six-month transformation project to understand why its close is slow. Start with five focused steps
1. Build a close timeline from actual activity
Use timestamps from the last two or three closes where possible. Record when tasks were ready, started, completed, approved, reopened, and finally signed off. Do not rely only on the planned calendar.
2. Identify the critical path
Find the tasks that determine when reporting can be finished. A task can be inefficient without being critical to the close date. Prioritize the steps that hold everything else up.
3. Classify each delay by cause
For each material delay, label the primary constraint: reporting, reconciliation, approval, data, integration, consolidation, manual work, system performance/configuration, or ownership. Then note whether the evidence points to process, technology, or both.
4. Test the easiest explanation first
Before buying software to solve a five-hour task, determine whether the task is slow because it starts two days late. Before rebuilding reporting, confirm that report definitions are agreed. Before automating approvals, check whether the approval chain is necessary.
5. Define the target outcome before evaluating tools
A good requirement is measurable and operational. “Close faster” is not enough. “Complete entity close by Day 3, complete consolidation by Day 4, and issue the management reporting pack by noon on Day 5 without manual workbook consolidation” is something a team can design and test against.
This creates a much stronger basis for evaluating whether the current ERP can be improved or whether a different system is justified.
What Evidence Suggests the ERP Really Is Part of the Problem?
An ERP change deserves serious consideration when the limitation is persistent, material, and difficult to solve through configuration or process redesign alone.
Common signs include:
- Finance repeatedly exports and recombines data because required reports are difficult to produce
- Multi-entity consolidation depends on manual workbook rollups
- Integrations are unreliable or difficult to monitor
- Approval or control requirements require extensive workarounds
- The data structure no longer reflects how the business needs to report or operate
The strongest evidence is repetition.
One awkward report is not an ERP strategy. A close process that loses significant time every month because the system cannot support the required operating model is a different problem.
Performance issues also need a careful diagnosis. If posting, reporting, or batch processing slows at period-end, check configuration, database performance, infrastructure, and integrations before assuming the application itself must be replaced.
Teams using Sage 300 should include those surrounding dependencies in the review.
What Evidence Suggests Process Redesign Should Come First?
Process redesign should usually come first when delays are driven by:
- Late or inconsistent cut-offs
- Unclear ownership
- Redundant approvals
- Repeated unresolved exceptions
- Inconsistent reconciliation methods
- Reporting definitions that change from month to month
Those problems can survive an ERP migration.
A new workflow tool can route an approval faster, but it cannot decide whether three approvals are necessary. A new reporting tool can produce a report faster, but it cannot resolve disagreement over how a KPI should be defined.
Technology still matters. But the target process needs to be clear enough that the system is solving the problem rather than automating the confusion.
What should a finance team bring into an ERP discussion?
If the diagnosis points to meaningful system limitations, bring evidence rather than a general request for “better automation.”
Useful evidence includes:
- Close activities that repeatedly create delays
- Manual reports or spreadsheet rollups
- Recurring reconciliation exceptions
- Integration failures or workarounds
- Approval bottlenecks
- Reporting or consolidation requirements the current system cannot support well
- The amount of time spent working versus waiting
That gives the ERP discussion a much better starting point:
What specifically needs to improve, and what would prove that the new design fixed it?
What Should a Finance Team Bring into an ERP Discussion?
If the diagnosis points toward meaningful system limitations, the finance team should bring evidence rather than a generic request for “better automation.”
| Bring this | Instead of this |
| A close timeline showing where elapsed time accumulates | “Our close takes too long” |
| A list of recurring reconciliations and exceptions | “We need automated reconciliations” |
| Defined management and statutory reporting requirements | “We need better reporting” |
| Integration data flows, owners, and failure points | “We have several integrations” |
| Current approval rules and exceptions | “We need workflow” |
| Entity and consolidation requirements | “We need multi-entity” |
| A target close calendar with measurable outcomes | “We want to be more efficient” |
This is useful whether the team is considering Sage 300 changes, evaluating Sage Intacct, or reviewing another financial system. It turns a product conversation into a requirements conversation.
Diagnose the Close Before You Diagnose the ERP
A slow month-end close is a symptom. The ERP may be part of the cause, but it is rarely the only place worth looking.
Reporting, reconciliations, approvals, data quality, integrations, spreadsheets, entity structure, cut-offs, and ownership can all affect when the books are truly ready.
Some problems belong to the system. Some belong in the process. Many involve both.
Start with a fact-based picture of the close: where time is spent, where finance waits, which exceptions recur, and which manual steps come from real system limits rather than accumulated habits.
Once that is clear, the options become easier to evaluate. The organization may improve the current environment, automate a specific bottleneck, or consider a broader ERP change when the system no longer supports the finance operating model.
For teams working through that diagnosis, ADSS Global’s Sage and ERP resources provide additional guidance on reporting, financial processes, integrations, and system evaluation.
The goal is simple: Identify the constraint first. Then decide whether the process, the configuration, or the ERP needs to change
